Multi-Story Placement Operations

Elevated Deck Concrete Pumping Jacksonville, FL

Engineered vertical standpipe routing, placing boom coordination, and high-pressure pipeline layouts. We manage the physics of multi-story concrete placement across Northeast Florida's commercial skyline.

180+ FT Direct Boom Reach
High-Pressure CX Pipelines
$5M General Liability Limits
ACPA-Certified Operators

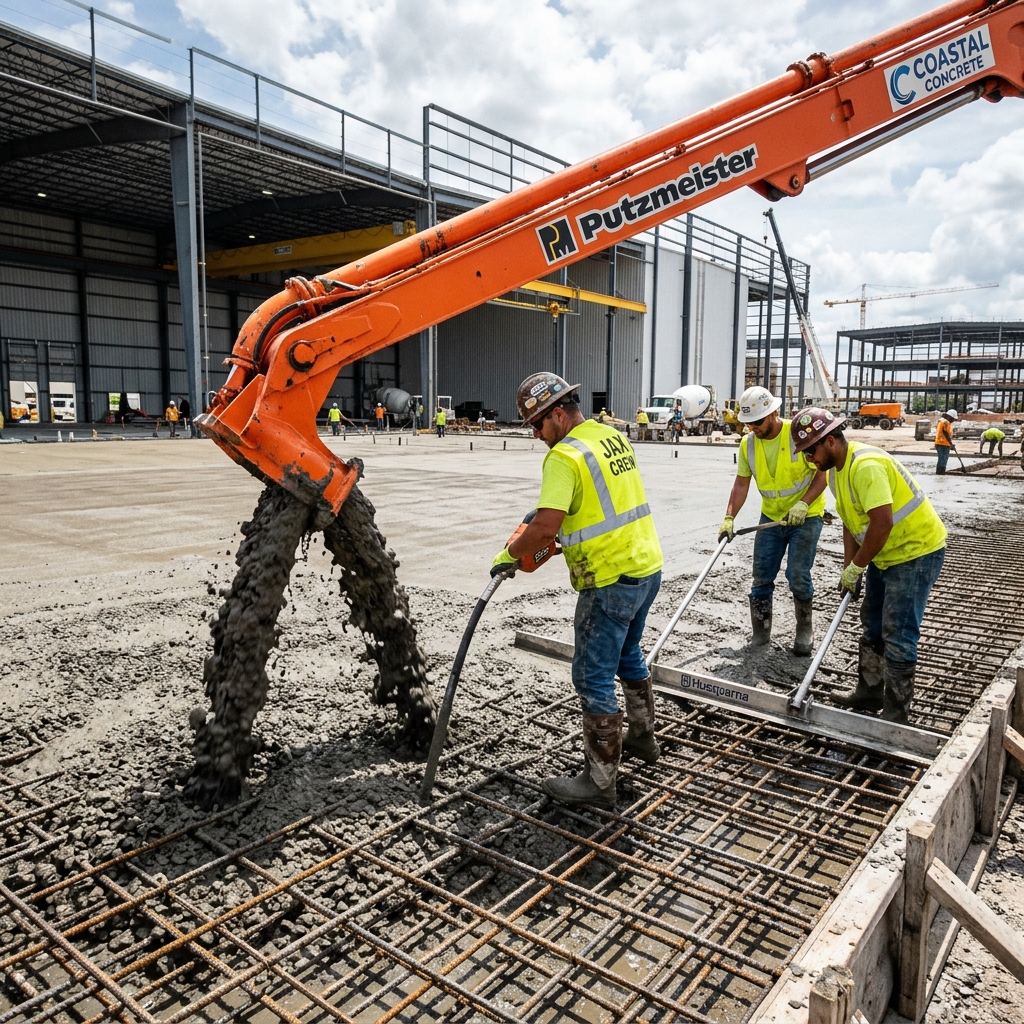

High-pressure multi-story concrete pumping operations showing pipeline standpipe routing and placer boom coordination
Multi-Story Placement — Downtown Jacksonville Skyline
180ft+
Max Vertical Boom Reach
350 PSI
Operating Line Pressure
5-IN
High-Pressure CX Pipelines
5M
Commercial Liability Limits

High-Pressure Standpipe Routing & Structural Anchoring

Pouring multi-story elevated concrete decks (like composite steel decking or post-tensioned slabs) means pushing tons of wet concrete straight up under immense mechanical load. When placement heights exceed what a standard 56-Meter boom truck can reach on its own, we transition our setup parameters to design and deploy a rigid **vertical high-pressure standpipe pipeline**.

Rigging a vertical standpipe is serious business. The riser pipeline has to be locked down tight using heavy-duty structural steel brackets clamped directly to the building's concrete columns or steel girders at maximum **10-foot intervals**. Down at the base, where the horizontal line transitions to the vertical riser, the pump exerts massive structural force. We require GCs to anchor a **reinforced concrete thrust block** at this transition elbow. This block absorbs the mechanical kick from the pump’s strokes, keeping the couplers from fatiguing and preventing the line from pulling apart under pressure.

"When you're pushing heavy mud up a vertical riser, the elbow at the base takes a beating. We anchor a reinforced concrete thrust block at that transition to absorb the mechanical kick and keep the couplings from fatiguing."

Placing Booms Staging & Structural Deck Loading

On sprawling elevated slabs where a standard boom truck cannot easily reach or reposition, we deploy modular **placing booms** that stage directly on your structural columns or custom placing towers. Because these systems place concentrated weight on structural floor plates, GCs must verify deck load capacities before we bolt down heavy placement machinery:

Column Curing

Your supporting columns must achieve 100% capacity strength before mounting towers to prevent concrete compression cracks.

Load Distribution

We deploy heavy composite dunnage pads under all placing tower legs to spread the shear weight safely across structural beams.

Washout Safety

You need a watertight washout setup on the active deck level to catch concrete slurry residue before it can drip and corrode structural steel below.

Our logistics coordinators work with you long before the pour date. We calculate exact outrigger loads and coordinate mounting plate specs directly with your engineering firm to ensure everything is 100% compliant and ready to pump.

Elevated Deck Dispatch Timeline

Multi-story placements leave zero margin for error. We follow a strict 5-step operational protocol for every vertical placement dispatched in Northeast Florida:

  1. 1

    Pre-Pour Standpipe Audit

    Our operator is on-site 1.5 hours before the mud arrives. We do a complete physical walk-down to inspect pipeline brackets, anchor clamps, wall ties, and check that the structural base thrust block is solid.

  2. 2

    Pressure Line Testing

    Before starting, we run high-pressure water through the line to check coupler seals and verify coupler integrity under working pressure before introducing concrete.

  3. 3

    Slicking & Line Priming

    We pump a concentrated slicking polymer slurry ahead of the first ready-mix load. This coats the dry steel walls of the riser pipeline so the concrete slides cleanly without packing the pipe.

  4. 4

    Sustained High-Pressure Pumping

    Once the pour starts, it has to stay moving. We coordinate closely with Cemex and Argos ready-mix plants to maintain a constant queue of trucks, preventing cold joints on the deck.

  5. 5

    Sponge-Ball Riser Cleanout

    At completion, we blow a pressurized sponge-ball through the riser. This pushes every yard of good concrete onto the deck, cleans out the pipeline, and collects the residue safely in washout bins.

Vertical Mix Matrix

Required concrete specifications for pushing mud up a vertical riser. We verify these mix parameters with your ready-mix supplier before scheduling the pump.

Required Slump 5.0" to 6.5" Slump
Higher flowability = lower friction
Max Aggregate 3/4-inch max size
3/8" pea gravel for vertical standpipes
Cement Paste Min. 6.5 sacks/yd³
High paste coats pipe interior
Admixtures HRWR Plasticizers
Maintains slump under pressure
Mix Design Parameters →

Standpipe Prep Checklist

Make sure you have these prerequisites fully squared away before our operator rolls onto the job. Avoiding delays keeps your project on schedule.

  • Structural columns supporting placing towers verified fully cured.
  • Wall bracket anchors clamped to girders at every floor level.
  • Base transition elbow supported by a reinforced concrete thrust block.
  • Watertight deck washout containment bags positioned at high levels.
  • Ready-mix delivery queuing coordinated for continuous flow.
Site Preparation Guide →
Engineering Parameters

Multi-Story Placement Parameters

Comparative specifications for low-rise vertical runs up to complex high-rise vertical placements.

Placement Height Riser Pipeline Spec Slump Target Recommended Admixture Max Aggregate
Low-Rise (Up to 35 ft) 5" Standard Steel Pipe 4.5" - 5.5" Slump None to Mid plasticizer 3/4" Round Gravel
Mid-Rise (35 to 120 ft) 5" Heavy-Wall Steel 5.0" - 6.0" Slump Mid-Range Retarder 3/4" Gravel (High Paste)
High-Rise (120+ ft) 5" High-Pressure CX Steel 6.0" - 7.0" Slump High-Range Water Reducer (HRWR) 3/8" Pea Gravel (Fine aggregate)

Environmental Compliance: FDEP Coastal Washout Rules

Under Florida Department of Environmental Protection (FDEP) guidelines, direct discharge of elevated slurry water into coastal aquifers or structural storm drainage is strictly prohibited. Watertight containment systems are mandatory for all elevated metal deck placements in Duval and Nassau counties.

GC Q&A

Elevated Deck Pumping FAQ

Common vertical placement and standpipe questions from Jacksonville developers and GCs.

What size vertical standpipe is required for high-rise concrete pumping? +

Most vertical runs are serviced using a rigid 5-inch steel standpipe. The heavy wall thickness is required to withstand working pressures up to 350+ PSI. Riser components are secured to structural columns with high-strength wall anchors at each floor plate.
How do you prevent pipeline blockages during a vertical pour? +

We follow a highly rigid protocol to eliminate blockage risks. We perform high-pressure hydrostatic coupling tests before starting, pump an engineered slicking polymer primer slurry through the riser, and maintain a constant ready-mix arrival queue to keep material moving continuously inside the standpipe.
Do placing booms require custom structural deck staging? +

Yes. Staging a static placing boom exerts massive localized loads on fresh structural floor plates. GCs must verify deck load metrics. We anchor placing boom towers directly to building columns that have achieved 100% curing strength and deploy dunnage cribbing to spread heavy shear weight.
