Rick — Trailer Operator (Jacksonville Concrete Pumping)
07:15 AM
Rig #14 is on site. Trailer staged safely at the curb. Deployed 180 feet of flexible 2-inch rubber line through the side fence gate. Gate measured 37 inches wide — line slides through easily. Hopper is primed. Ready for first truck.
07:18 AM
Dan — Pool Finisher (GC)

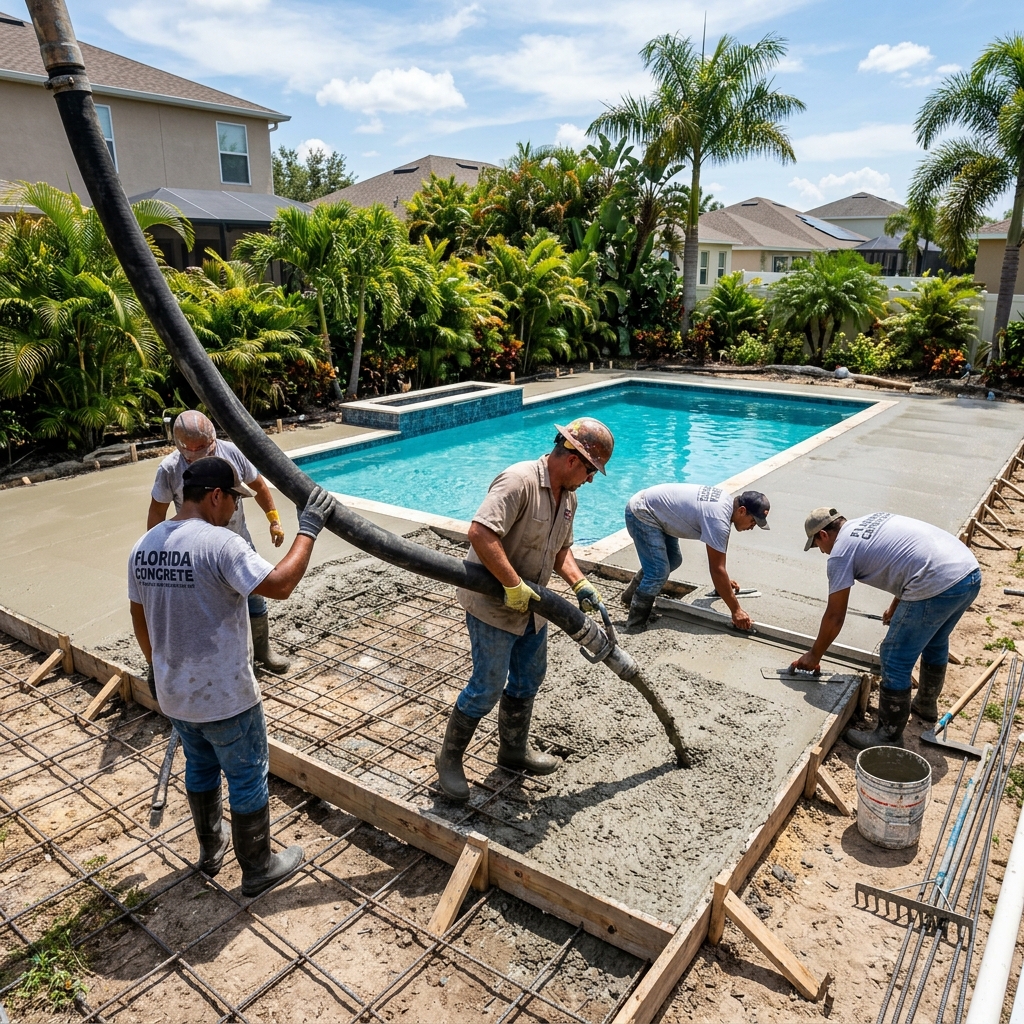

Perfect. Forms are set and double-braced. We've got the washout bags pinned in the driveway. The lawn is completely clear. First truck is pulling up in Mandarin now.
Rick — Trailer Operator (Jacksonville Concrete Pumping)
07:45 AM
Argos truck #1 backed in. Slump is measuring 3.5 inches. This is too stiff for the 2-inch reducing slickline. High risk of line plug in the elbow. I am holding the pump. Argos dispatcher: please adjust admixture.
Argos Dispatcher — Southside Plant
07:48 AM
Copy that, Rick. Driver is instructed to add 30 oz/yd³ of high-range water reducer (plasticizer) into the drum. Spin it for 30 revolutions. Do not add water to the drum. Let us know when slump clears.
Rick — Trailer Operator (Jacksonville Concrete Pumping)
07:53 AM
Admixture spun. Measured slump is now 4.75 inches. Flow is excellent. Pumping active at 18 yards per hour. Tell the plant to space Mixer #2 exactly 25 minutes out.
08:45 AM
Dan — Pool Finisher (GC)
All 28 yards placed. Slickline washout completed into containment bags. Lawn and driveway look perfect. Crew is finishing the aggregate border now. Outstanding job, guys!
